“Day 34 To Day 49”

Cypress Log Home Construction

Day 34- Roofing, Window & Door Delivery

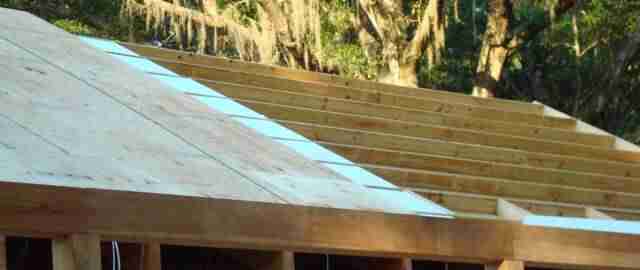

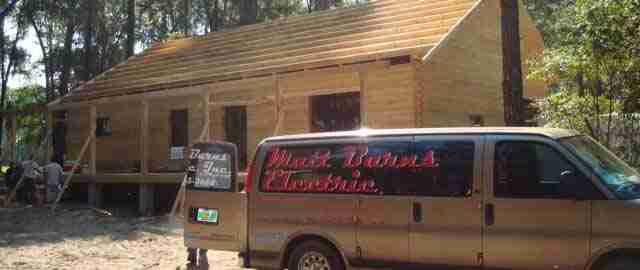

October 11th, Monday Day 34 – Electricians onsite met with the Owner’s and laid out all electric and installed all ceiling drops with wiring rough. Exterior metal clad windows and doors delivered. Log Crew installing roof insulation panels and roof decking

Day 35- Working on roof and setting porch post and header beams

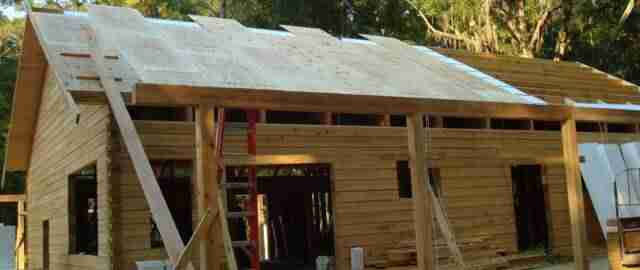

October 12th, Tuesday Day 35 – Log Crew installing insulation, roof decking and working on cypress open beam porches. Setting Cypress Headers and 6″ x 6″ Cypress Porch Post. Building Dept. on site today and signed off on roof sheathing inspection.

Day 36- Finish decking T&g on porch roofs

October 13th, Wednesday
Day 36 – Log Home Builder working on  covered porch roof.

Day 37- Install roofing membrane, now Log Home roof is safe and dry

October 14th, Thursday Day 37 – Log Crew working on porches and installing roof underlayment
Shamrock Construction Day 37

Day 38- Plumbing Rough-in starting

October 15th, Friday Day 38 – Log Home Builders Crew working on interior wall framing. Plumbers onsite working on rough in.
Shamrock Construction Day 38

Day 39-40- Log home interior framing

October 16th, Saturday
Day 39 – Crew working on interior wall framing. Plumbers onsite working on rough in.

Day 40 – October 17th, 2010 Sunday – No Work

Shamrock Construction Day 39

Day 41- Log Home Window & door Bucking Install

October 18th, Monday
Day 41 – Log Crew working on window and door bucking and front covered porch system. Plumber onsite working on rough in.

Shamrock Construction Day 41

Day 42 Window & Door bucking and framing on custom bay window

October 19th, Tuesday Day 42 – Crew working on window bucking and bay window. Plumbers onsite working on rough-in. Electricians onsite working on rough-in. Hardwood and tile subcontractor onsite measuring layout for finish floors and shower hops.
Shamrock Construction Day 42

Day 43- Setting log home Door and windows

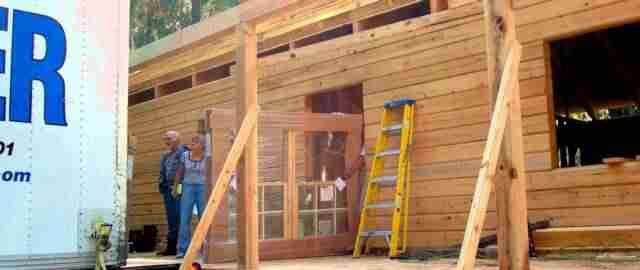

October 20st., Wednesday Day 43 – Crew installing windows. Framing bay window. Plumbers onsite working on rough-in and installing waterline to well.
Shamrock Construction Day 43
Shamrock Construction 2 Day 43
Shamrock Construction 3 Day 43

Day 44-46- Misc Items, Bay window framing

October 21th, Thursday
Day 44 – Log Crew framing 6/0 x 6/10 doors. Completing log to roof transition. Framing bay window.

October 22nd, Friday
Day 45 – Log Home Crew working on misc. items, HVAC crew onsite, met with the owner and laid out all vents/returns and installed ductwork.

October 23rd, Saturday
Day 46 – Log Crew working on misc. items

Shamrock Construction Day 45
Shamrock Construction 2 Day 45
Shamrock Construction 3 Day 45

Day 47-48 Metal roof measurements, plumbing, all roof penetrations

October 24th, Sunday
Day 47 – No Work

October 25th, Monday

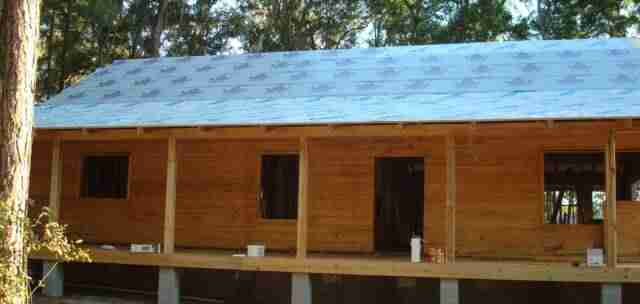

Day 48 – Log Home Building Crew working on misc. items, drop ceilings, elect. cutouts, finished sheathing bay window and set both 6/0 x 6/10 exterior doors. H.V.A.C crew onsite, met with owner and laid out last 2 vents that were in conflict with floor structural members. “H.V.A.C rough-in complete.” Plumbers onsite, set tub and finishing rough-in. Metal roof contractor onsite taking finish roof measurements and ordered metal to be delivered tomorrow. Coordinated and completed all roof penetrations with roofing contractor (H.V.A.C, Plumbing, and Gas) Metal roof installation scheduled to start Wednesday.

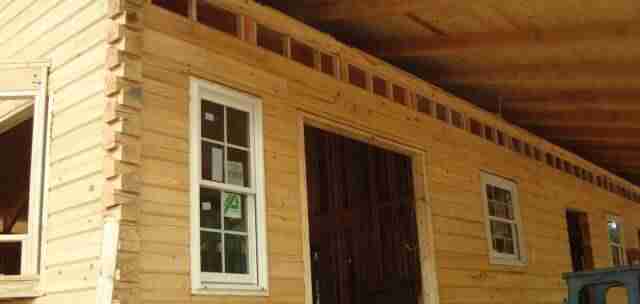

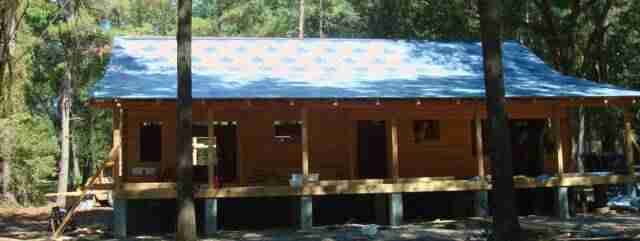

Shamrock Construction Day 48

Day 49- Fireplace & misc.

October 26th, Tuesday Day 49 – Log Crew working on misc. items and framing fireplace. ” Plumbers onsite, finishing rough-in. Metal roofing delivered. Meeting onsite with owners to discuss porch rails and picket design.
